Germantown Public Works Projects
Annual Road Program
Time Frame
Summer 2026
Project Overview
The Village asphalt program replaces asphalt pavement that has deteriorated to a level that routine maintenance is no longer effective. The typical approach is to replace the top 2-4 inches. Roads with larger structural issues may receive a more intense rehab.
The Village conducts an every-other-year inspection of its roads to determine condition. In addition to condition, traffic volumes and utility projects factor into the programming.
Linked is a 10-year outlook for the asphalt paving program. The out years are highly variable and will be reassessed multiple times. The current year and next year forecast are firmer. The DPW-Engineering Division recommends checking this page annually for the status of construction activities on your road.
Road Program / Germantown, WI - Official Website
Sealcoating Program
Time Frame
Summer 2026
Project Overview
The Village conducts preventative maintenance on asphalt roadways by applying a variety of sealcoating techniques. These techniques are used on roads with generally good sufficiency ratings. Each sealcoating technique has an application and a point in a surfaces lifecycle where it is most appropriate. The earliest surface application on a road could take place in as few as 2-3 years after construction.

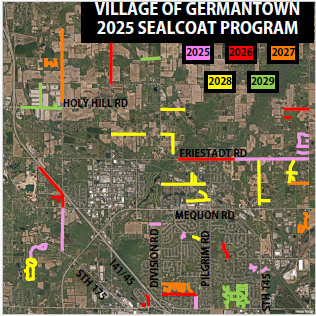

Linked is a 5-year outlook for the asphalt sealcoating program. The current year and next year are more firm plans, years 3-5 are subject to annual re-evaluation. The DPW-Engineering Division recommends checking this page annually for the status of sealcoating on your road.
County Line Road and Appleton Ave. Traffic Signal Upgrade
Time Frame
2026
Project Overview
The Village secured a Wisconsin DOT Signals and ITS Standalone Program (SISP) grant covering 90% of the cost to replace the traffic signals and some street lighting at County Line Road and Appleton Avenue. The design work will take place in the early part of 2026 with construction in the summer. This project will replace some of the oldest traffic control infrastructure in the Village.
Division Road Reconstruction
Time Frame
SUMMER 2026 - Phase 1 Construction - Mequon Road to Jefferson Creek
2026 - Phase 2 Design - Jefferson Creek to County Line Road
2027 - Phase 2 Construction - Jefferson Creek to County Line Road
Project Overview
Public outreach was conducted in the summer of 2024. Design for Phase 1 is nearing completion. Construction activities are expected to begin in 2026. The project will be divided into two phases. Phase 1 will be north of the Jefferson Creek. Phase 2 will be south of Jefferson Creek. Upgrades to the Old Farm lift station and forcemain will be coordinated with Division Road construction in 2027.
The project will look to improve safety and connectivity while also doing a standard pulverize and reconstruct on the existing asphalt. The Village is anticipating replacing the current path with an 8’ path and extending the path on the west side in select locations.
Division Road Bridge Repair over Jefferson Creek
Time Frame
2026
Project Overview
Following the August 2025 rain and flooding event staff identified material protecting the north abutment had been scoured out and deposited west of the bridge. An inspection following the storm confirmed the abutment is no longer protected and material will need to be placed back to properly protect the structure from future high flow events. A consultant has been hired to design the repair. Construction is expected in the summer of 2026. The bridge is safe for traffic until the repair is conducted.
Maple Road Bridge Repair over Goldendale Creek
Time Frame
2026
Project Overview
Routine bridge inspections conducted by Washington County on behalf of the Village identified several repairs needed on this bridge. A consultant has been hired to design the repair. Construction is expected in the summer of 2026. The bridge is safe for traffic until the repair is conducted.
Pleasant View Road Reconstruction - Lovers Ln to Freistadt
Time Frame
Design - 2026
Construction - 2026/2027
Project Overview
In January of 2025 the Village of Germantown was awarded an approximately $2.5M grant from the Wisconsin Department of Transportation (WISDOT) as part of their Agricultural Road Improvement Program (ARIP). Under the ARIP program Rockfield Road from STH 145 to Division Rd, and Pleasant View Rd from Bonniwell Rd to Freistadt Rd will be reconstructed. This included segments of Rockfield Rd in the Town of Germantown through an agreement between the two municipalities. The majority of this work was completed in the summer of 2025, but a large culvert structure at the Menomonee River and Pleasant View Road will be reconstructed in 2027. The road in this segment will also be reconstructed.
Old Farm and Main Street Lift Station Upgrades
Time Frame
Design - 2026
Construction - 2027/2028
Project Overview
Recent planning efforts and studies indicate that key lift stations in the Wastewater Utility need to be upgraded to accommodate growth in the Village as well as address key lifecycle maintenance and replacement needs. In 2026 the Village will select an engineering firm to design these upgrades with the anticipation that construction will take place beginning in 2027.
Right-of-Way Tree Planting Project
Time Frame:
Spring 2026
Project Overview:
Each year trees around Germantown are removed for various reasons which include vehicle damage, storm damage and disease. Germantown currently has an estimated 306 “vacant” planting sites where trees once existed.
Staff work to maintain the urban tree canopy by planting a portion of these vacant sites annually. Trees provide significant value to our community, but the most prevalent would be the aesthetic value that can be seen as you travel our roadways and walk in our parks.
This year’s project will replace 90 trees in the Village, along roadways, around Village buildings and parks and within residential areas. During the planting you may notice activity in the right-of-way adjacent to your home. This could include staff activity, marking planting locations, and actual planting of trees.
Right-of-Way Tree Prunning Project
Time Frame
Late – 2026
Project Overview
In accordance with Germantown's Comprehensive Tree Plan, DPW will conduct an urban tree pruning project. The project will prune nearly 300 trees south of Mequon Avenue and east of Division Road. Reference 'Year 2' in the graphic to the right.
Routine pruning provides a number of important benefits, including disease prevention, shaping and thinning, clearances along roadways and utilities, and reduces potential liability by removing unhealthy limbs and deadwood. Project specifications were developed in accordance with ANSI A300, which is an industry standard, and routinely utilized in the pruning of urbanized settings. Work will be conducted primarily in the right-of-way adjacent to the front and side yards of properties.
Water Meter Replacement
Time Frame
2026
Project Overview
The Water Utility replaces commercial and residential water meters on a regular basis to remain compliant with the Public Service Commission’s rules. If you home is scheduled for a water meter replacement you will be notified by the Water Utility staff in advance to schedule the work.
